Benchmarking Project Costs: Cyprium Metals’ Nifty Project vs. SHERPA Estimates

Accurate cost estimation is essential for credible mine development—especially for brownfield projects aiming to restart operations after extended care and maintenance. Cyprium Metals’ Nifty copper project in Western Australia is a case in point. Restarting this legacy site depends on a lean execution strategy and efficient capital deployment. But how do the company’s internal estimates compare to industry-standard benchmarks?

In this cost analysis, we compare Cyprium’s capital and operating cost projections for Nifty with estimates generated by Costmine’s SHERPA modeling software. SHERPA provides independent, detailed, and data-driven projections built on standardized logic and current market inputs. By benchmarking against SHERPA, project developers can validate assumptions, flag potential omissions, and strengthen budgeting confidence early in the project lifecycle.

SHERPA’s Break Down of Operating and Capital Costs

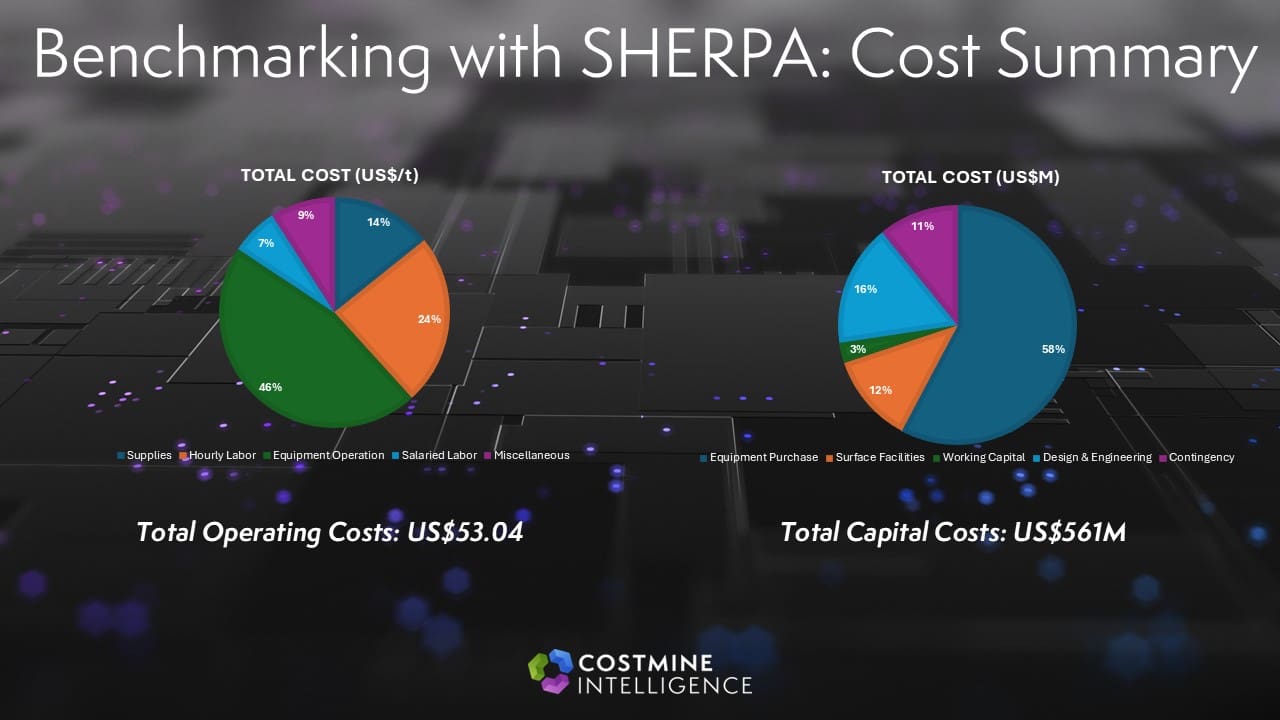

Using SHERPA, the Nifty project was modeled under the same production and processing assumptions disclosed by Cyprium, but with a more inclusive cost framework. SHERPA estimated total capital costs at US$561 million, significantly higher than Cyprium’s reported A$402 million. This discrepancy is primarily driven by SHERPA’s incorporation of full indirect costs, including infrastructure, construction management, and escalation allowances. These are often underrepresented or deferred in owner-generated estimates, especially in restart scenarios where legacy infrastructure is expected to carry forward.

On the operating side, SHERPA’s model returned a total cost of US$53.04 per tonne, compared to Cyprium’s estimate of A$57.10 per tonne. While the difference is smaller in relative terms, it reflects a broader scope of modeled cost categories in SHERPA’s structure—such as labor, energy, maintenance, and site overheads—that may be optimized or streamlined in Cyprium’s internal approach. Importantly, these differences in assumptions accumulate over the life of mine and can materially impact long-term financial projections.

Cyprium’s Nifty Project: Break Down of Operating and Capital Costs

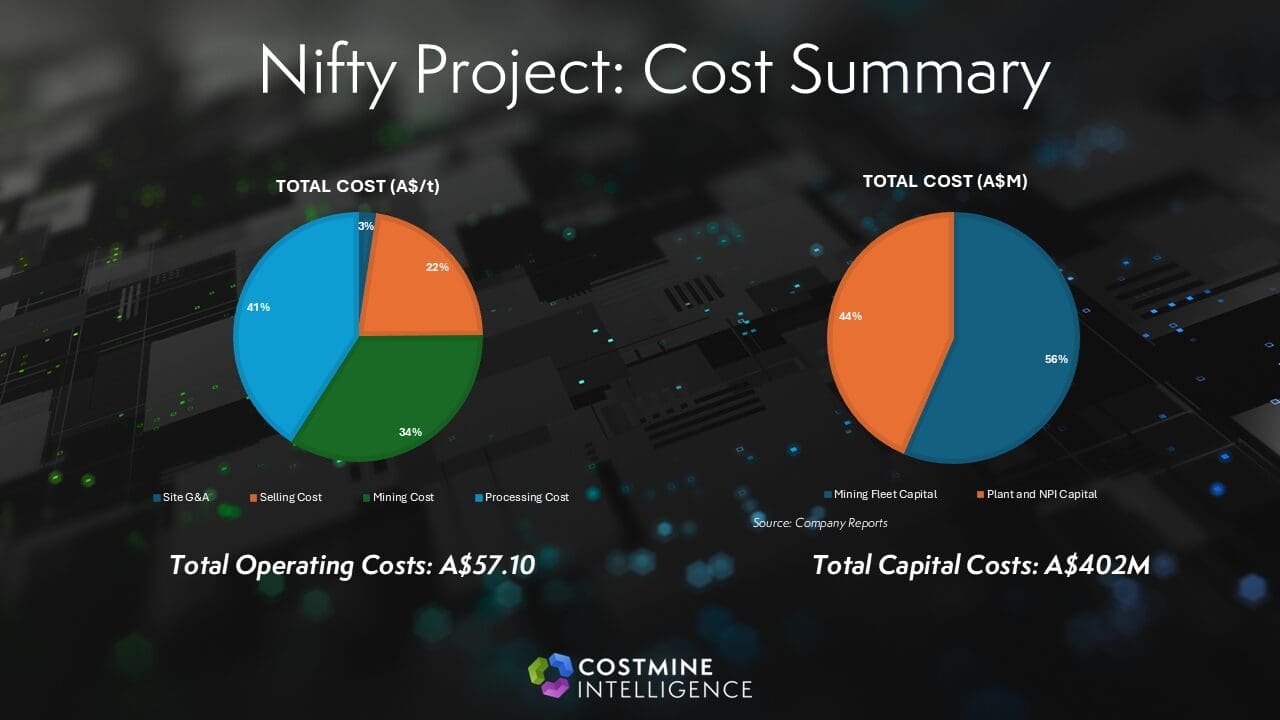

Cyprium Metals has positioned the Nifty restart as a low-capex, rapid-execution brownfield project. With capital costs reported at A$402 million and operating costs of A$57.10 per tonne, the company’s plan leverages the site’s existing processing plant, mine development, and infrastructure to reduce upfront investment. These estimates appear to be focused and tightly scoped—appropriate for a staged ramp-up—but may carry greater cost sensitivity if key indirects or contingencies are excluded.

The lean capital profile may appeal to equity and debt markets, but benchmarking against a more conservative, bottom-up model like SHERPA highlights areas where costs could escalate if conditions deviate from plan. This is especially relevant in brownfield contexts, where assumptions about legacy infrastructure usability, workforce availability, and material conditions are often optimistic.

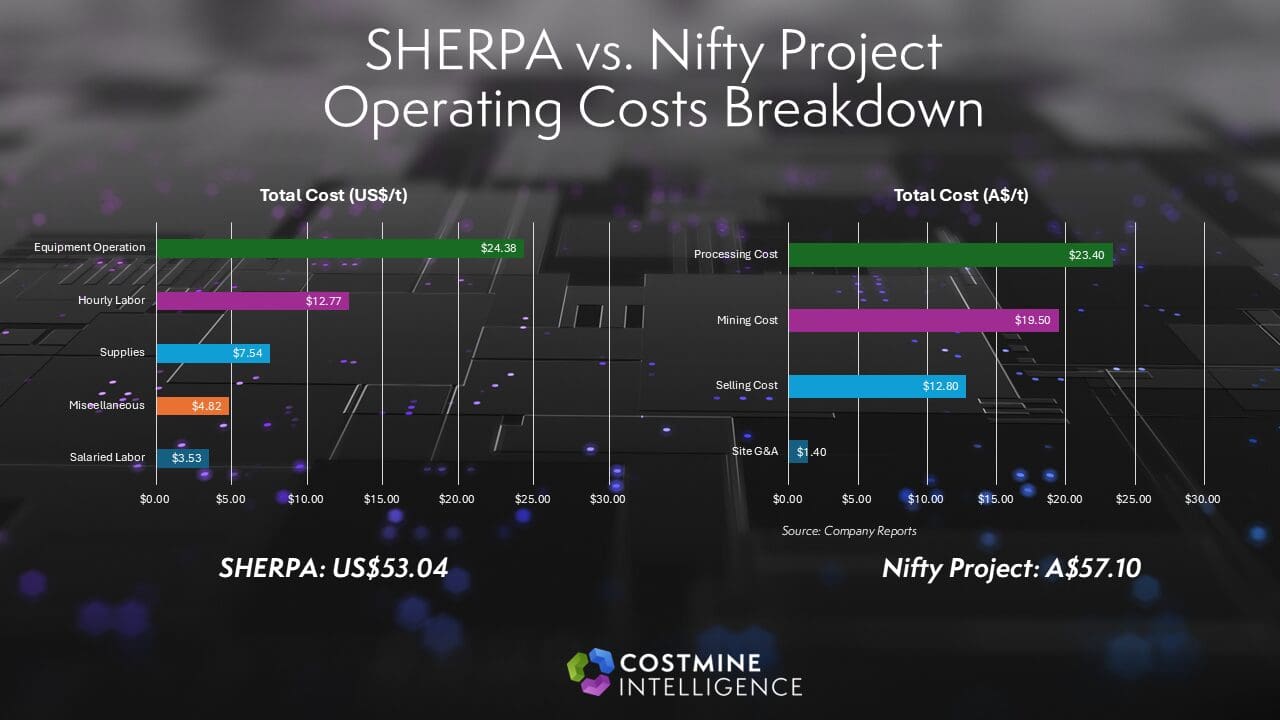

Total Operating Costs Comparison between SHERPA and Cyprium Metals

Though the difference is only a few dollars per tonne, the impact over life-of-mine tonnage is significant. The fact that SHERPA’s more inclusive model still results in a lower cost per tonne suggests that Cyprium’s restart assumptions may be aggressive or reliant on ideal conditions. SHERPA’s model offers a conservative, but still competitive, cost benchmark that validates core assumptions while flagging possible cost blind spots.

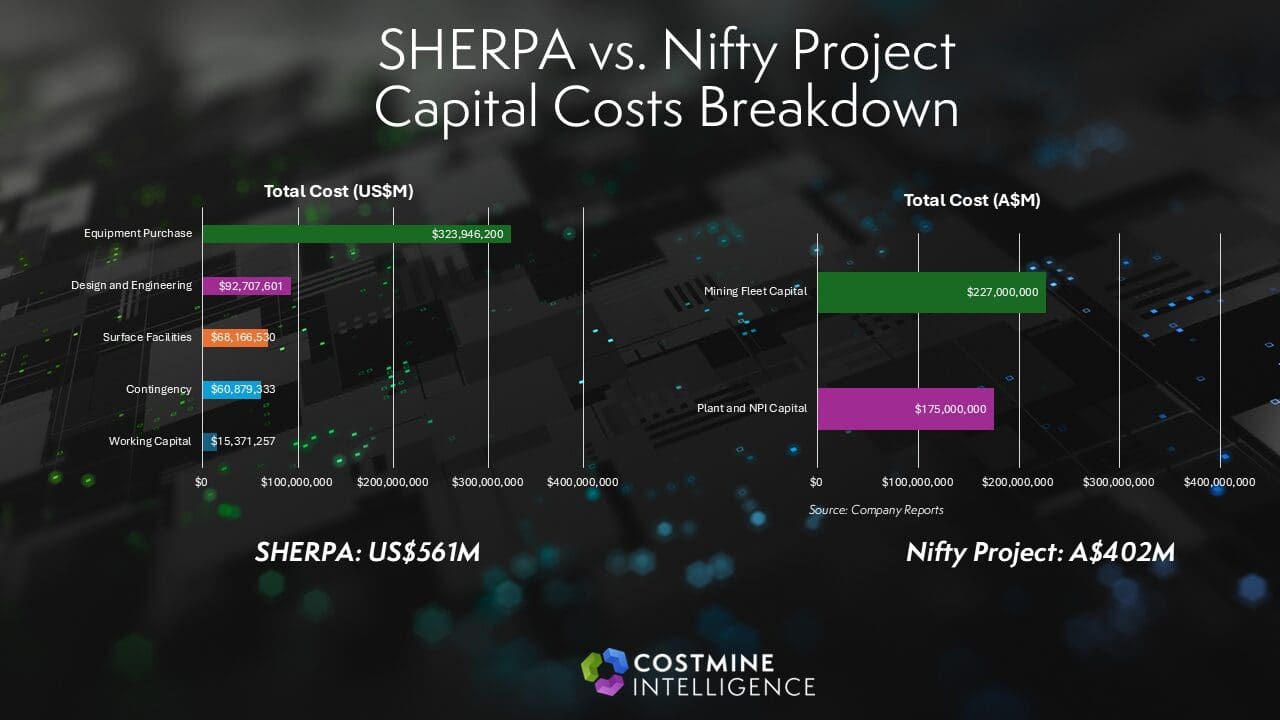

Total Capital Cost Comparison between SHERPA and Cyprium Metals

The capital estimate variance is substantial and underscores the importance of benchmarking during early-stage planning. SHERPA’s model includes indirects, owner’s costs, and escalation—critical elements that are often deferred or excluded in internal scoping studies. For developers, the risk is not just underestimating the total build cost, but also being unprepared for the timing and sequencing of those outlays. Benchmarking ensures that hidden costs are identified early, improving the accuracy of financial models and funding strategies.

Why Benchmark with SHERPA?

SHERPA allows developers to test their internal assumptions against a transparent, repeatable cost framework built from real-world inputs. For brownfield projects like Nifty, where legacy infrastructure can distort expectations, SHERPA helps de-risk the process by identifying categories that might be overlooked or underestimated. The model’s integration with the Mining Cost Service ensures that every input—whether labor, materials, or equipment—is based on current, location-adjusted benchmarks.

In this case, SHERPA’s broader scope offers a more conservative but still competitive picture of Nifty’s economics. By validating the project’s cost structure, it supports more reliable budgeting, financing, and execution planning.

Learn more about SHERPA here: SHERPA | Costmine Intelligence

Want to learn more about Costmine Intelligence and how we can help you streamline your with your mining data needs?

Request a demo with a member of our team to get a personal assessment and discover what tools and data meet your needs.

Chris Berry

Vice-President Sales

Request a Demo

Related Insights

Content

Mining Intelligence Follows Equinox Gold’s Acquisition of Calibre Mining

Equinox Gold has completed its business combination with Calibre Mining, forming a diversified gold producer with operations across the Americas. The combined portfolio is anchored by Greenstone in Ontario and the nearly commissioned Valentine mine in Newfoundland & Labrador—positioning Equinox as Canada’s second-largest gold producer. We’re watching this consolidation closely as part of ongoing M&A trends tracked in Mining Intelligence.

Content

The Cost Benefit of Mine Site Solar Power

This article revisits hybrid diesel-solar PV systems in two remote Northwest Territories communities with under 200 residents. It highlights the modest but valuable role of solar, the high cost of adding battery storage, and the limited efficiency of hybrid setups due to prolonged winter darkness requiring continued diesel use.

Data Showcase

SHERPA v. Nifty Project Comparison – Excel Data Download

In this analysis, Costmine Intelligence used SHERPA—our proprietary cost modeling software—to replicate the project’s assumptions and calculate capital and operating costs based on current market rates, location-adjusted inputs, and a fully scoped cost framework.

Free Data and Insights Delivered Directly to Your Inbox

Sign up for our newsletter to get regular updates on our products, along with free data, recommended posts on our Insights channel, and special opportunities.

Name(Required)
This field is for validation purposes and should be left unchanged.
